Palm Bay P&Z Takes Up Concurrency Rules and 2,360-Home Development on the Same Night

New public safety standards and a 2,360-home development land on the same P&Z agenda.

Listen to this article

0:00
-14:29

Palm Bay, FL -- Wednesday’s Planning and Zoning Board meeting carries an unusual combination on its agenda. The city is bringing forward a comprehensive plan amendment to formally adopt measurable fire and police response standards for the first time. The same night, it is asking the board to recommend approval of a 1,198-acre development at the northwest intersection of St. Johns Heritage Parkway NW and Melbourne-Tillman Canal -- a project that will add an estimated 5,900 residents to an area that already doesn’t have the fire station or police staffing to serve it at those standards.

The meeting begins Wednesday, April 1, 2026 at 6:00 PM in City Hall Council Chambers, 120 Malabar Road SE.

The City Wants Measurable Standards

CP26-00001 is a proposed amendment to the Capital Improvements Element of Palm Bay’s Comprehensive Plan. The city’s Growth Management Department is proposing for the first time to set specific, legally enforceable level-of-service (LOS) standards for fire rescue and police response times. The amendment cites nationally recognized frameworks: NFPA 1710 for fire, and CALEA and IACP guidelines for police.

For fire, the proposed standard requires first-due suppression units to arrive within four minutes travel time for at least 90% of priority incidents, a full effective response force within 8 minutes, and EMS within 6 minutes. The effective response force standard matches NFPA 1710 exactly. The EMS standard is also consistent with national guidance. On the police side, the proposed standard sets Priority 2 response at 7 to 8 minutes and Priority 3 at 10 to 15 minutes, benchmarked against CALEA and IACP guidelines.

The Gap Between the Standard and Today

The political logic behind adopting these standards now is straightforward: without formally adopted LOS benchmarks, the city has no legal mechanism to require developers to fund public safety infrastructure improvements as a condition of project approval. The amendment creates that mechanism.

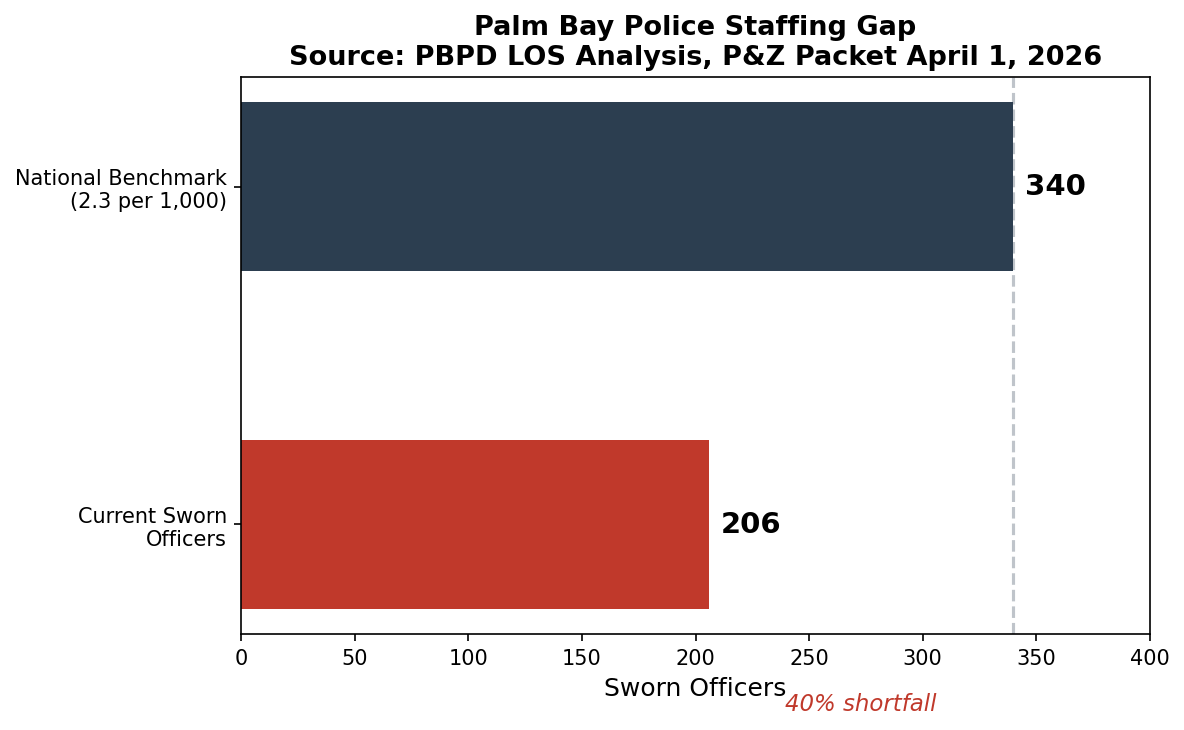

What the city’s own departments are saying about current conditions is equally straightforward. Palm Bay Police Department checked “No” on its own development review form filed with the Palm Vista packet when asked whether the city currently meets the state and national benchmark of 2.3 sworn police officers per 1,000 residents. The department has approximately 206 sworn officers. At 2.3 officers per 1,000 residents for Palm Bay’s current population, the benchmark requires roughly 340. The department’s own analysis calls that a 40% shortfall. The department also noted that 12 officer positions were requested in the prior year’s budget for this service area and were not funded.

Palm Bay Police Staffing Gap
Palm Bay Police Staffing Gap

Fire presents a different version of the same problem. Fire Station 3, at 790 Jupiter Blvd NW, is the closest existing station to the SJHP growth corridor. ESO-measured average response times from Station 3 to the area run 7 minutes 30 seconds to 7 minutes 55 seconds. The proposed first-due standard is 4 minutes of travel time. Proposed Fire Station 8, at Malabar Road SW and St. Johns Heritage Parkway, is the station that would close the coverage gap. It appears in the Capital Improvements Plan with $1.85 million in FY2026 funding and $10.28 million in FY2027. It does not yet exist.

The CIP picture beyond those three near-term stations is thin. Of the $95.2 million in the five-year fire CIP, approximately $35.8 million is financially committed. The remaining $59.4 million is listed as “No” on current funding commitment. That includes seven unfunded line items: Stations 6, 10, 11, 12, 13, 14, and the Station 2/Headquarters rebuild, serving the city’s projected growth corridors. On the police side, the department’s single major capital project is a $57 million new headquarters, Phase 1. That project is also not financially committed. There are no substations in the FY26-30 CIP, despite the proposed LOS amendment language stating that “police substations shall be planned to maintain adopted response-time LOS standards.”

Palm Bay Fire CIP: Committed vs. Unfunded
Palm Bay Fire CIP: Committed vs. Unfunded

The city is not pretending otherwise. The amendment’s mitigation framework is explicit that when adopted standards are projected to be deficient as a result of new development, the city shall require proportionate-share contributions. That framework only works if the standards exist. Right now, they don’t. Wednesday is the night the city tries to change that.

Palm Vista Everlands West: Who Is Millrose, and What Are They Asking For?

The largest item on the agenda is a pair of related applications: CP25-00005, a large-scale Future Land Use Map amendment, and PD25-00003, a Preliminary Development Plan for a Planned Unit Development. Both are filed by Millrose Properties Florida, LLC, with Ana Saunders, P.E., of BSE Consultants, Inc. in Melbourne serving as the applicant’s representative.

Millrose Properties is a real estate investment trust that was spun off from Lennar Corporation in February 2025. Lennar contributed approximately $5.5 billion in land assets to seed the new company. Kennedy Lewis Capital Management handles Millrose’s investment management. The company is headquartered in Miami. Palm Vista Everlands West is, in Lennar’s own SJRWMD paperwork, referred to as “Palm Vista Phase 3” -- the western half of the Everlands master plan. The eastern phases are already partially built or entitled, including Riverwood, Timbers, and Edgewood, totaling approximately 1,640 units on the east side across multiple phases. The 2,360 units now before P&Z represent the western half of the Everlands master plan. Ordinance 2016-79 authorized up to 4,000 total units for the full Everlands project.

The property spans approximately 1,198 acres at the northwest intersection of SJHP NW and the Melbourne-Tillman Canal. The application requests a rezoning from Brevard County Agricultural Residential to City PUD, with a preliminary development plan for 1,600 single-family homes, 760 multifamily units, and 145,000 square feet of non-residential commercial uses. The development timeline runs from a projected Q2 2026 construction start on the first pods through a 2036 buildout. Construction could begin within weeks of a Council approval.

Staff recommends approval of both applications. The recommended approval includes concurrency conditions, but those conditions defer the actual determination of fire and police adequacy to the Final Development Plan stage. Approval Wednesday does not resolve the concurrency question.

What the City’s Own Analysis Shows at Buildout

The city’s traffic engineer analyzed the road network in January 2026 using 2024 baseline counts and a 2035 buildout year. Three road segments will exceed their level-of-service capacity when Palm Vista reaches buildout, even accounting for background traffic growth independent of this project:

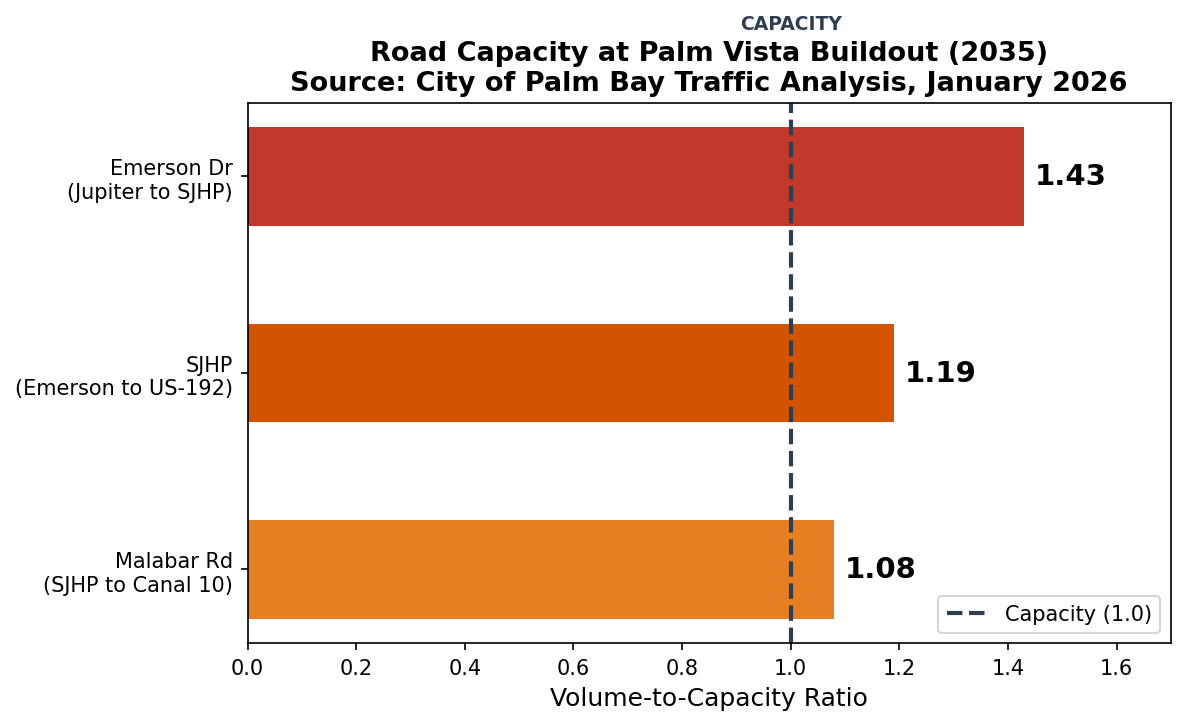

Emerson Drive from Jupiter Boulevard to SJHP is the worst-performing segment, projected at a volume-to-capacity ratio of 1.43. A ratio of 1.0 means a road is at capacity; 1.43 means the road would carry 43% more traffic than it is designed to handle. Emerson is currently a two-lane road. The staff analysis requires widening it to four lanes as a mitigation condition.

SJHP between Emerson Drive and US-192 is projected at a 1.19 V/C ratio, requiring widening from four to six lanes. Malabar Road between SJHP and Canal 10 is projected at 1.08. Required mitigation also includes intersection improvements at multiple points and traffic signal warrant studies at three of the four development access points on SJHP -- those studies are a condition of approval, meaning they have not been completed yet.

Road Capacity at Palm Vista Buildout
Road Capacity at Palm Vista Buildout

Lennar acknowledged in its own project narrative that “negotiations regarding transportation improvements and/or proportionate share contributions have not yet commenced.” Transportation impact fees are estimated at $14.7 million.

On schools, Discovery Elementary is the concurrency service area school for the project. The School Board of Brevard County issued a capacity determination in August 2025 finding that Discovery Elementary “is not projected to have enough capacity for the total of projected and potential students from the Palm Vista Everlands-West development.” The projected new elementary-age students are 355. The resolution is to assign those students to adjacent service areas, including Jupiter, Lockmar, Allen, and Meadowlane. That determination is also labeled non-binding. A formal concurrency determination by the School District is required before a Final Development Order can issue.

Utility adequacy -- water and wastewater -- is contingent on the South Regional Water Reclamation Facility being available and operational. The HR Green engineering memorandum states this explicitly as an assumption. The packet contains no documentation confirming construction status or timeline for that facility. On the environmental side, approximately 370 acres of the 1,198-acre site are wetlands. The SJRWMD Environmental Resource Permit has not yet been obtained. Army Corps coordination was initiated previously but must restart due to changes in the federal definition of Waters of the United States.

The Corridor Behind the Project

Palm Vista is one of several developments along the St. Johns Heritage Parkway, but the corridor has a geography that matters. SJHP consists of two disconnected segments. The northern segment runs approximately 2.5 miles from Malabar Road to Emerson Drive and serves the Everlands projects, Cypress Bay Preserves, Willowbrook, and now Palm Vista. The southern segment is 1.67 miles from Babcock Street to the I-95 interchange, serving Rolling Meadow Lakes and the Babcock corridor projects. A gap of approximately 14 miles separates the two segments. Construction of the connecting link has no funded design or build plan as of March 2026.

Traffic impacts from the northern and southern segments are separate. A car from Palm Vista does not travel the same road as a car from Rolling Meadow Lakes. But city services do not recognize that division. Fire stations, police staffing, schools, and utilities serve the entire corridor regardless of which segment a development sits on. Looking at the northern segment alone, cumulative residential development includes the Everlands phases, Cypress Bay Preserves, Willowbrook, and Palm Vista, totaling roughly 9,900 units. The southern segment adds Rolling Meadow Lakes at 2,000-plus units. Combined, the corridor is on a trajectory toward approximately 11,900 units and an estimated 29,770 new residents. That load falls on a city that, as of Wednesday, does not yet have a formally adopted public safety LOS standard and has 40% fewer police officers than the national benchmark for its current population.

Other Business: Two Variances and a Housekeeping Update

The board will also hear two variances Wednesday evening.

V26-00001 involves a replacement screen room enclosure at 299 Evergreen Street NE. The applicant, Valerie R. Mc Farlane, is requesting a variance to allow the enclosure to encroach 3.5 feet into the 8-foot side-yard accessory setback under Section 174.002 of the Code of Ordinances. Staff recommends approval.

V25-00003 involves an existing carport at 1521 Toy Street SE. Applicants Alyson R. Williams and Thomas Lee Williams are seeking a variance to allow a carport that already exceeds the height of the principal structure by 3 feet, 7 inches (for a total height of 18 feet, 8 inches) and exceeds the cumulative allowable size of accessory structures by 411 square feet, under Sections 174.002(B) and 174.002(D). Staff recommends denial for this one.

CP26-00002 is a housekeeping amendment to update references in the Coastal Management Element and Intergovernmental Coordination Element so that emergency protective measures for evacuation and sheltering cite the current Brevard County Comprehensive Emergency Management Plan. This is an administrative alignment, not a policy change.

Sources

  • City of Palm Bay Planning and Zoning Board Agenda, Regular Meeting 2026-04, April 1, 2026

  • CP26-00001 Staff Report and Proposed Comprehensive Plan Language, pp. 421-459, P&Z Packet April 1, 2026

  • CP25-00005 Staff Report (FLUM Amendment), pp. 58-75, P&Z Packet April 1, 2026

  • PD25-00003 Staff Report (Preliminary Development Plan), pp. 173-190, P&Z Packet April 1, 2026

  • Palm Bay Police Department LOS Analysis, CP25-00005, pp. 139-141, P&Z Packet April 1, 2026

  • Palm Bay Fire Rescue LOS Analysis, CP25-00005, pp. 135-138, P&Z Packet April 1, 2026

  • HR Green Water/Wastewater System Evaluation, January 15, 2026, pp. 129-133, P&Z Packet April 1, 2026

  • City of Palm Bay Public Works Traffic Analysis (January 2026), pp. 126-128, P&Z Packet April 1, 2026

  • Brevard Public Schools Capacity Determination CD-2025-15, August 5, 2025, pp. 104-111, P&Z Packet April 1, 2026

  • CIP Master Project List FY26-30, pp. 434-459, P&Z Packet April 1, 2026
